Skip to content

Defence and aerospace manufacturing · Llangeinor, Bridgend

Irvin-GQ parachute manufacturing — commercial rooftop solar, South Wales

Commercial rooftop solar PV across the main production hall and second-bay roof: structural feasibility survey, panel layout design, NGED G99 Type A connection, twin-inverter installation with dedicated 415V distribution, SolarEdge-equivalent monitoring, commissioning and aftercare.

Client
Irvin-GQ Limited
Location
Llangeinor, Bridgend
Project value
approximately £160,000
Completed
September 2025
System size
180 kWp
Annual generation
171,000 kWh
Annual saving
£42,000
Payback period
2.8 years

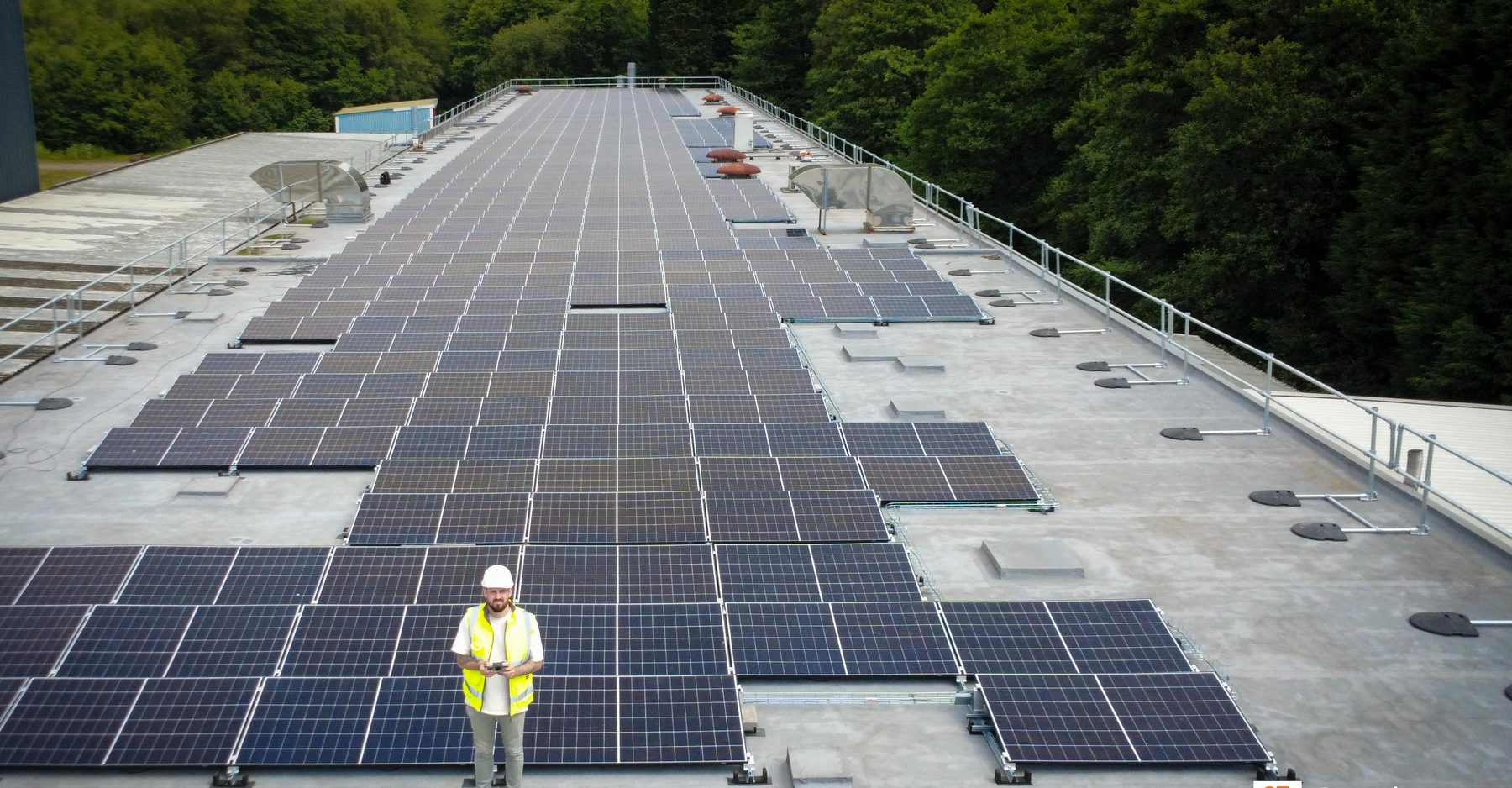

Aerial view of completed 180 kWp commercial solar array on Irvin-GQ industrial roof, South Wales

Completed array on the main south-facing production hall roof — aerial overview

Aerial view of solar panel installation on the second bay of Irvin-GQ facility

Panel layout across the secondary roof bay

Twin Solis 5G Series commercial solar inverters in plant room at Irvin-GQ

Twin Solis 5G Series inverters commissioned in dedicated plant room

Solis 5G Series solar inverter with DC isolator in commercial plant room at Irvin-GQ

Inverter DC isolator and cable management detail

415V HV distribution board with inverter circuit breakers at Irvin-GQ

415V distribution board with dedicated inverter protection

Irvin-GQ main roof walkthrough — May 2026
The challenge

The challenge

Irvin-GQ is a defence and aerospace manufacturer supplying parachute and aerial-delivery systems into Ministry of Defence and NATO programmes. The facility runs a continuous daytime production load with precision sewing, testing rigs and compressed-air plant operating across two shifts. Two immediate constraints sat on top of the standard commercial rooftop brief. First, the buildings carry a large south-facing main roof and a secondary lower-pitch bay with different structural profiles, which meant a single blanket panel layout would not work. Second, the customer had a board-level deadline aligned to financial year-end and a Scope 3 reporting commitment cascading from their MoD customer base, so the project could not slip.

Our solution

Our solution

FLD ran a full structural feasibility survey on both roof bays before finalising the layout. The main production hall roof was designed at the highest panel density it could carry, with the secondary bay taking the balance of the 180 kWp specification. Panel routing avoided existing plant penetrations, roof walkways and maintenance access points. We submitted a G99 Type A application to NGED in parallel with procurement, compressing the overall lead time. Installation was phased across the two roofs so that production was never stopped. In the plant room, twin Solis 5G Series commercial three-phase inverters were installed with dedicated 415V distribution and circuit protection, a full cable-management run, and remote monitoring commissioned for live generation data. A single NICEIC Approved Contractor sign-off covered the complete installation.

The result

The result

G99 approval landed in nine weeks. Installation was completed on schedule with zero production stoppages across either shift. Year-one generation is tracking within 1.8% of the PVGIS model. The client subsequently commissioned FLD to scope battery storage addition to capture afternoon surplus against overnight site load, and is progressing with the Scope 3 reporting integration into their MoD supply-chain disclosures.

FLD delivered a difficult twin-roof installation to the financial-year deadline without stopping production for a single shift. The commissioning documentation was audit-ready from day one.

— Irvin-GQ Limited
